    Resource Library|Missouri Owner-Builder Guide
    Complete Owner-Builder Guide

    Missouri Owner-Builder Guide

    SIP Shell Construction: From Permit to Move-In

    This guide covers every phase of building a Solid-Core SIP Homestead Shell as an owner-builder in Missouri — permitting, land, financing, the panel package, shop drawings, delivery, assembly week, mechanical rough-in, and getting to move-in. It's a long read. It's worth it.

    11
    Chapters
    3–5
    Days to Erect
    R-26+
    Wall Performance
    Completed rural Homestead Shell illustrating the goal of the Missouri owner-builder planning process
    Bottom Line Upfront

    Building a SIP Homestead Shell as a Missouri owner-builder is genuinely achievable — and Missouri's lack of a statewide building code makes it one of the most owner-builder-friendly states in the country. The key insight most people miss: the hardest part isn't the construction. The hard parts are the decisions that happen before you break ground — land, financing structure, permit research, and shop drawing approval. Get those right, and assembly week practically runs itself. DreamStart provides your EPS panel pricing documentation from Graettinger, Iowa with everything pre-planned. Your job is to be ready to receive the panels and have Your local builder standing by for assembly.

    What This Guide Is

    This guide was written for one specific person: a Missouri landowner (or soon-to-be landowner) who wants to build their own home using SIP panel construction and who isn't afraid to do the work — but also isn't interested in learning expensive lessons on the fly.

    It draws on SIPA (Structural Insulated Panel Association) technical best practices — the same documentation used by commercial SIP manufacturers — and translates that into plain-English, Missouri-specific guidance. Where the SIPA docs are written for engineers and architects, this guide is written for you.

    DreamStart Building Company is an EPS Authorized Dealer based in St. Joseph, MO — a home designer providing EPS panel pricing documentation. Your local builder secures panels directly from EPS at DreamStart's quoted pricing; those panels are factory-cut in Graettinger, Iowa. We've walked owner-builders through this process from concept to move-in and we've seen where people get stuck. This guide is designed to make sure you don't get stuck in those same places.

    Not sure if owner-building is right for you?

    Before working through this guide, take five minutes with the owner-builder readiness checklist. It covers land, financing, site, and timeline assumptions that shape every decision in this guide.

    What "Shell Construction" Means

    DreamStart coordinates the Homestead Shell — the complete structural and insulated envelope of your building. DreamStart advises on the design and provides your EPS panel pricing documentation; the assembly labor is separately quoted and contracted through a local builder you hire. The shell scope includes the foundation-to-ridge SIP walls, SIP roof, all rough openings, framing, engineered connection details, and sealing. What it does not include is interior finish work: drywall, flooring, cabinetry, plumbing fixtures, electrical fixtures, HVAC equipment.

    The shell is the hard part to get right. Once the shell is up and weather-tight, the interior finish work follows a much more conventional path — and you can do it yourself, hire subs, or phase it over time.

    PhaseWho Does ItTypical Timeline
    Land & site prepOwner / site contractorVariable — weeks to months
    Permit research & applicationOwner (DreamStart provides docs)2–8 weeks
    Financing approvalOwner / lender3–8 weeks
    Design & shop drawingsDreamStart + EPS manufacturer4–8 weeks after deposit
    Panel fabricationEPS factory in Graettinger, IA3–5 weeks after drawing approval
    Delivery & site stagingOwner / local GC crew1 day
    Shell assemblyYour local builder3–5 days
    Mechanical rough-in (HVAC/electric/plumbing)Owner / licensed subs4–8 weeks
    Interior finish to move-inOwner / subs (phased OK)3–18 months depending on scope
    Chapter 1

    Is Owner-Building Right for You?

    An honest look at what it takes — and what it doesn't require.

    Let's skip the pep talk and be direct about what owner-building a SIP shell actually demands — and what it doesn't.

    What It Requires

    • Land you own (or are under contract on) with confirmed buildability — zoning, access, no deed restrictions against residential construction
    • Time to manage the process: permit research, lender communication, shop drawing review, subcontractor coordination. Plan on 5–10 hours per week for 3–6 months before assembly week.
    • A realistic budget with contingency — 10–15% above your estimated shell cost is standard
    • The ability to get a telehandler (all-terrain forklift) on site for delivery day — panels are up to 8' × 24' and weigh up to 800 lbs
    • A local builder you hire handles assembly and truck unloading/panel staging — DreamStart helps you connect with one; you coordinate site access and ensure the foundation is ready
    • Willingness to do the reading: shop drawings, connection details, moisture management — this guide covers the critical items

    What It Doesn't Require

    • A contractor license — Missouri owner-builders can pull permits under their own name in counties that require them
    • Previous SIP experience — that's what Your local builder crew brings
    • SIP assembly skills of your own — DreamStart provides your EPS panel pricing documentation and technical documentation; a local builder you hire separately quotes and performs the assembly
    • An enormous budget upfront — phased construction is real and common; get the shell up and weather-tight, then finish interior over time
    • Perfect land — you'd be surprised how workable a challenging site can be with the right foundation plan
    The Owner-Builder Advantage
    An owner-builder who manages their own subs, their own permit process, and their own interior finish work will typically save 20–35% compared to hiring a full general contractor for the same build. On a $200,000 project, that's $40,000–$70,000 in your pocket — or into upgrades.

    The Honest Challenges

    Time is the real currency. Every delay in your build — permit waiting, financing approval, shop drawing revisions, weather, subcontractor availability — costs you carrying costs on your land and/or your construction loan. The people who struggle most with owner-building aren't the ones who run into problems; they're the ones who didn't anticipate that problems were coming.

    Decision fatigue is real. You will make hundreds of decisions during a build. The ones that matter most happen early: floor plan, foundation type, wall height, roof pitch, window placement. Get these locked down before shop drawings start.

    Subcontractor availability varies by region. In rural Northwest Missouri, finding a good electrician or plumber who is familiar with SIP construction (or willing to learn) can take longer than expected. Start your sub outreach 6–8 weeks before your projected shell completion.

    One Thing to Get Right Early
    Make your financing decision — cash or loan — before you start any design work. If you're financing, your lender will have requirements (inspections, draw schedules, approved contractors) that affect your entire build sequence. Cash buyers have far more flexibility in how they phase the work.
    Chapter 2

    Missouri Permits & Zoning

    What you actually need — county by county — and how to find out fast.

    Missouri has no statewide residential building code. That's not a loophole — it's state policy. Each Missouri county decides independently whether to adopt a building code and which code to adopt. The practical result: most rural Missouri counties outside city limits have no building permit requirement for residential construction.

    This is a genuine advantage for owner-builders and one of the main reasons Missouri is such a strong market for homestead and barndominium construction. But "no permit required" is not the same as "no rules." Read this section carefully.

    The Three Scenarios You'll Encounter

    Scenario A: No Adopted Code (Most Rural Missouri Counties)

    No county permit required for residential construction in unincorporated areas. You can break ground without pulling a permit. Your lender, however, may still require engineered drawings and an inspection process — that's a lender requirement, not a code requirement. Septic system and well permits are separate (Missouri DNR / county health).

    Scenario B: Adopted Code, Active P&Z Office

    County has adopted IBC or IRC. You'll need a building permit with plan review. Timeline: 2–6 weeks typical. DreamStart coordinates custom architectural drawings (included with your design deposit) that satisfy most county plan review requirements. Engineering stamps are coordinated only when your county or lender requires them. Budget for permit fees: typically $200–$1,500 depending on county and square footage.

    Scenario C: Within City Limits or Incorporated Area

    City permits almost always required regardless of county code status. Most cities have adopted the IRC or IBC. Some have additional overlay requirements (floodplain, historic district, aesthetic standards). If your land is inside any city limits, research the municipal code before purchasing.

    Best Owner-Builder Counties in Missouri

    These Northwest Missouri counties have no adopted residential building code and a strong culture of rural residential construction — making them the most flexible environments for owner-builders:

    CountyCode StatusP&Z OfficeDrive to St. Joseph
    Andrew CountyNo code (outside Savannah)Minimal~20 min
    Atchison CountyNo codeNone outside Rock Port~45 min
    Nodaway CountyNo codeNone outside Maryville~55 min
    DeKalb CountyNo codeMinimal~30 min
    Davies CountyNo codeNone outside Gallatin~45 min
    Caldwell CountyNo codeMinimal (Cameron area)~35 min
    Clinton CountyP&Z exists, issues permitsActive (816-539-3722)~25 min
    Ray CountyNo code outside RichmondMinimal~50 min
    Carroll CountyNo codeNone outside Carrollton~65 min
    Always Verify Before You Buy Land
    Code adoption can change. A county that had no code in 2022 may have adopted the IRC in 2024. Always call the county assessor's office or planning and zoning office directly before purchasing land and ask: "Does your county require a building permit for a new single-family residence in an unincorporated area?" Get the answer in writing if possible.

    What DreamStart Provides for Permitting

    • Engineered drawings (structural, architectural, foundation) coordinated through American Iron or VR Home Design & Drafting — included with the $9,750 design package, which includes a Walk Your Plans visit to walk your full-size floor plan and make final changes. Engineering stamps are coordinated only when your county or lender requires them
    • SIP manufacturer engineering documentation and EPS Authorized Dealer certification
    • Panel-specific load calculations and connection details
    • Energy code compliance documentation (relevant in counties that have adopted IECC or equivalent)
    • Guidance on what to bring to your first meeting with the county P&Z office

    What Always Requires a Permit (Regardless of Building Code)

    Even in zero-code counties, these items typically require separate permits or approvals:

    • Septic system installation — Missouri DNR oversees this through county health departments; a licensed installer is required
    • Well drilling — Missouri DNR well construction permit required statewide; licensed driller required
    • Access driveway permit — county road department or MODOT for highway access points
    • Floodplain development — if your land is in a FEMA-mapped floodplain (AE or AO zones), development permits are required regardless of local code status
    • Electrical service connection — your electric co-op or utility will have their own inspection requirements for service entrance and meter base
    Chapter 3

    Land, Site & Foundation

    Everything below grade and before the first panel goes up.

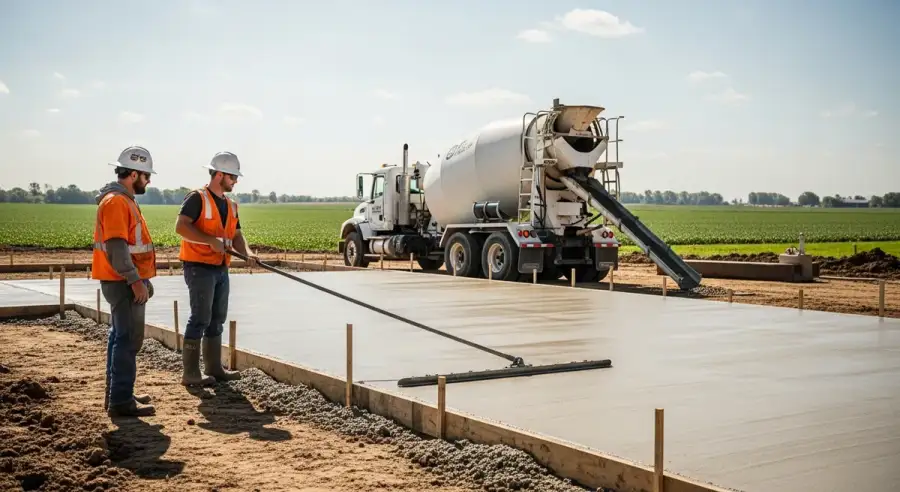

    Concrete slab foundation being poured and finished on a rural Missouri building site

    Your foundation is the most permanent, least forgiving thing in your entire build. SIP walls are forgiving in many ways — but they require a square, level foundation. Any error in your slab or stemwall translates directly into difficulty during panel installation.

    Land Selection Checklist

    • Confirm zoning allows residential construction — call county P&Z or assessor
    • Check deed restrictions and covenants — HOAs and deed covenants can restrict construction type even when county code doesn't
    • Check FEMA flood map (msc.fema.gov) — floodplain parcels have significant restrictions and insurance consequences
    • Confirm road access — county or township road? Who maintains it? Can a flatbed semi get to your site?
    • Percolation test if septic required — conduct before finalizing land purchase
    • Check for easements (utility, pipeline, drainage) that may limit where you can place the structure
    • Verify electric service availability — rural electrification co-ops sometimes have multi-month lead times for new service
    • Confirm cell/internet service if important to you — this is rural Missouri, and coverage varies significantly

    Site Preparation

    Before your foundation crew arrives, the site needs to be cleared, rough-graded to within a few inches of final grade, and accessible by heavy equipment. At a minimum:

    • Clear trees and brush from the building footprint plus at least 20 feet on all sides
    • Establish a driveway / access route that can handle a semi-truck (delivery) and a concrete pump truck (foundation)
    • Rough grade the building pad — target within 6 inches of final elevation across the footprint
    • Stage an area at least 40' × 60' adjacent to the building footprint for panel staging during delivery
    • If doing septic, coordinate with your site contractor to avoid disturbing the drainfield area during site prep

    Foundation Types for SIP Construction

    SIP walls can be built on any conventional foundation type. The most common for Homestead Shell construction in Missouri:

    Monolithic Slab (Most Common)

    A single pour integrating the footing and slab. Cost-effective, works well on flat to gently sloping sites. Requires accurate layout — your SIP walls will be anchored directly to the slab perimeter. Treated sill plate is installed over a capillary break material before walls go up. Plan for your plumbing rough-in to be stubbed through the slab before the pour.

    Stemwall / Crawlspace

    CMU block or poured concrete stemwall with a crawlspace. Useful on sloping sites and preferred by some lenders. Provides access to under-floor plumbing after construction. More expensive than slab. SIP walls bear on the stemwall top plate — again, level and square are critical.

    Full Basement

    Poured concrete or ICF basement walls with SIP first-floor walls above. Significantly more expensive but adds substantial usable square footage. Works well on sloped sites where daylight basement is possible. Not commonly used for initial owner-builder builds due to cost.

    Critical: Capillary Break at SIP-to-Concrete Interface
    This is non-negotiable. SIP wall facers (OSB) must never be in direct contact with concrete — moisture will wick into the OSB and cause long-term damage. A sill gasket or capillary break material (rubber, foam tape, or synthetic sill sealer) must be installed between the treated sill plate and the concrete. Your foundation contractor may not know this — make sure it happens.

    Foundation Accuracy Requirements

    SIP panels are factory-cut to exact dimensions based on your approved shop drawings. If your foundation is out of square or out of level, the panels won't fit as designed — and fixing it in the field is expensive and time-consuming. Hold your foundation contractor to these tolerances:

    • Square to ±⅛ inch across any 20-foot diagonal measurement
    • Level to ±¼ inch across the entire perimeter
    • Anchor bolt placement per the engineered drawings — bolts in wrong locations will require field correction
    • Slab surface (if applicable) within ¼ inch of flat across any 10-foot span
    Chapter 4

    Your SIP Package — What DreamStart Coordinates

    Understanding what's in the box and how it all goes together.

    Factory-cut SIP panels staged in preparation for a documented shell project

    Not all SIP packages are the same — even from the same manufacturer. DreamStart provides your EPS panel pricing documentation as an RTA (Ready-to-Assemble) package, which is the highest level of factory prefabrication available. Understanding what that means — and what distinguishes it from cheaper alternatives — is worth your time.

    Three Levels of SIP Fabrication

    Package TypeWhat ArrivesField Labor RequiredBest For
    Blank SIPsRectangular panels, uncutEverything — all cutting done on siteExperienced SIP fabricators with complete drawings
    Prefabricated SIPsPanels cut to size; openings roughed inSpline and plate installation, final fit and sealMost standard builds
    RTA Package (coordinated by DreamStart)Panels cut, headers installed, beam pockets cut, plates included, all rough openings fully framed and sizedPanel assembly, connection, sealingOwner-builders; maximum speed; minimum field skill required

    The RTA advantage isn't just speed — it's quality consistency. Factory precision CNC cutting produces openings to ±⅛ inch tolerance. Field cutting on a busy jobsite, under time pressure, with rotating crew members, rarely achieves that.

    What's in a DreamStart Homestead Shell Package

    • Solid-Core EPS SIP wall panels — 6.5" nominal thickness (R-26+ whole-wall performance), factory-cut to your floor plan
    • SIP roof panels — 8.25" to 12.25" thickness depending on span and climate zone (R-40+ performance)
    • Internal lumber splines, headers, and beam pockets — factory installed
    • Base and top plates — included and pre-sized
    • SIP screws and fasteners — included per manufacturer specification
    • Panel sealant, expanding foam, and SIP tape for air sealing all joints
    • Shop drawings showing every panel's ID number, position, and connection details (engineering stamps coordinated only when your county or lender requires them)
    • Factory-cut electrical chases at standard outlet and switch heights (14" and 48" from floor), 4' on center
    • All rough openings sized per your window and door schedule
    • EPS Authorized Dealer documentation for permitting

    Panel Specs You Should Know

    Panel TypeNominal ThicknessR-Value (nominal)Typical UseMax Panel Size
    Wall SIP6.5"R-23 nominal / R-26+ whole-wallExterior walls8' × 24'
    Roof SIP (upgrade)8.25"R-29 nominalShort spans, low-pitch roofs8' × 24'
    Roof SIP (heavy)10.25" – 12.25"R-38 to R-49 nominalLong spans, high-performance roofs4' × 24'
    SIP with I-joist splineVariablePer panel specSpans up to 24' without intermediate support4' × 24'
    Why a Lower R-Value Can Actually Outperform a Higher One
    The Department of Energy's Oak Ridge National Laboratory tested full wall assemblies — not just insulation in isolation. A 4-inch SIP wall (nominal R-14) outperformed a 2×6 wall stuffed with R-19 fiberglass in real-world whole-wall testing. That's a wall with a lower stated R-value winning. The reason: SIPs eliminate thermal bridging (no studs conducting heat every 16 inches) and have dramatically lower air leakage — DOE testing showed a SIP structure had only 7% the air leakage of a conventional stick-frame building. Air movement is the enemy of real-world thermal performance — and SIPs stop it cold.

    Electrical Chases — What's Pre-Cut and What Isn't

    This is the item owner-builders most often misunderstand. Here's exactly what comes factory-cut in your panels and what requires field work:

    Factory-Cut Electrical Chases (Standard)
    • Horizontal chase at 14" from panel bottom — outlet height
    • Horizontal chase at 48" from panel bottom — switch height
    • Vertical chase approximately every 4 feet on center
    • 1.25\" diameter chase — adequate for standard 14/2 and 12/2 wire runs
    Field Work Required
    • Sill plates and top plates must be drilled to connect to chase locations — done during panel installation
    • Electrical box openings cut with 4" hole saw at chase intersections during rough-in
    • Additional chases requested before fabrication (no field cutting of SIP faces without manufacturer approval)
    • Interior wall wiring — conventional stick-framed interior walls have no chases; run conduit or open-frame typically
    Never Cross-Cut SIP Facings in the Field
    The OSB facers are structural elements — they carry tension and compressive loads. Cutting across (perpendicular to) an OSB facer in the field without manufacturer or engineer approval compromises the structural integrity of that panel. This is one of the most common and most costly mistakes in SIP construction. If you need an additional chase or opening, call DreamStart before cutting.
    Chapter 5

    The Shop Drawing Process

    What to expect, what to review, and why this stage deserves your full attention.

    Floor-plan drawing used to review layout decisions before SIP shop drawings are approved

    Shop drawings are the SIP manufacturer's detailed fabrication plan for your specific building. They're different from your architectural drawings — they show panel IDs, sizes, layouts, spline locations, opening dimensions, electrical chase positions, and connection details for every single panel in your structure.

    The shop drawing stage is where precision happens. It's also where most project delays originate — not because the process is hard, but because owners don't engage with it quickly enough.

    The Shop Drawing Timeline

    StepWho ActsTypical Duration
    Architectural drawings submitted to DreamStartOwnerDay 1
    DreamStart submits to EPS factory for shop drawing developmentDreamStart1–3 business days
    Factory creates SIP layout drawings (3D model + panel sheets)EPS manufacturer1–3 weeks
    Shop drawings sent to owner for reviewEPS manufacturer → Owner—
    Owner reviews, marks corrections ('red-lines'), approves or requests revisionOwnerShould be < 5 business days
    Revisions incorporated (if any)EPS manufacturer3–7 days
    Final approval signed and returnedOwnerSame day as review
    Production beginsEPS factoryNext business day after approval
    Fabrication complete, delivery scheduledEPS factory / DreamStart3–5 weeks after approval

    What to Review on Your Shop Drawings

    When your shop drawings arrive, don't sign and return them the same day without careful review. The factory cuts your panels exactly per these drawings — a wrong dimension here means a field correction later. Check every single one of these items:

    • Overall building dimensions — does the footprint match your architectural plan exactly?
    • All rough opening dimensions — window and door openings must match your window/door schedule precisely (width and height)
    • Rough opening placement — verify horizontal centerlines and sill heights match your interior layout intent
    • Wall heights — confirm they match your desired interior ceiling heights (accounting for panel thickness and floor/ceiling assemblies)
    • Roof pitch — verify slope matches what's shown on your architectural elevation drawings
    • Panel thickness — confirm wall and roof panels are the specified thicknesses
    • Ridge detail — the ridge joint is the most critical air sealing point in the structure; verify the detail matches the manufacturer's approved ridge sealing spec
    • Electrical chase layout — do the standard chase locations work for your intended outlet and switch placement?
    • Special conditions — beam pockets, point load locations, cantilevered roof sections, any non-standard configuration
    The Ridge Joint — Read This Carefully
    SIP buildings create a "stack effect" — warm air inside rises and finds the highest available gap to escape. That gap, if not properly sealed, is the ridge joint. The ridge joint is the single most important air sealing detail in your entire structure. your local GC crew follows the manufacturer's ridge sealing specification exactly — but you need to understand it during the shop drawing review. Ask to see the ridge detail and make sure it's clearly shown on the drawings.

    What Happens if You Request Changes After Approval

    Changes after shop drawing approval trigger a design revision process that can add 1–3 weeks and potential re-fabrication costs depending on what's changed and how far into production the factory is. This is the number one reason to take the review period seriously and not rush to sign off. One extra day of thorough review can save two weeks of delay.

    Chapter 6

    Financing Your Build

    Options that work for SIP construction — and the lender conversation you need to have early.

    Financing a SIP owner-builder build has become significantly more straightforward in the last decade as barndominium and alternative construction financing has matured. That said, not all lenders understand SIP construction, and not all loan products work for an owner-builder. Here's the landscape.

    Financing Options That Work

    USDA Rural Development (Best Option for Most Missouri Owner-Builders)

    USDA Section 502 loans are specifically designed for rural residential construction. Zero down payment. Below-market interest rates. Most rural Missouri parcels qualify for USDA geographic eligibility. SIP construction is eligible — you'll need your engineered drawings (with stamps coordinated when your lender requires them) and EPS Authorized Dealer documentation. Income limits apply.

    Best fit: Owner-builders in rural Missouri counties building primary residence. Strong for first-time rural builders.

    Construction-to-Permanent Loan

    A single loan that covers the construction phase (interest-only draws as work is completed) and converts to a permanent mortgage at completion. Avoids two closings. Requires lender approval of builder credentials — DreamStart's EPS Authorized Dealer status and engineering documentation typically satisfies this. Farm Credit Services and local community banks are most flexible for this product in rural Missouri.

    Best fit: Buyers who want a single loan, can document construction milestones, and have adequate credit score (typically 680+).

    VA Loan (For Veterans)

    VA construction-to-perm loans are available for eligible veterans. No down payment. No PMI. VA has specific inspection requirements during construction. Missouri has strong VA loan activity — especially in areas near Fort Leonard Wood and Kansas City. DreamStart's documentation package is designed to support VA construction loan applications.

    Best fit: Eligible veterans building primary residence.

    Cash Purchase / Phased Self-Finance

    The most flexible option and increasingly common for owner-builders. Pay for each phase as you go — land, site prep, shell, then interior in stages. No lender requirements or draw inspections. No interest carrying costs. Many owner-builders build the shell on cash and finance the completed home once it meets conventional mortgage requirements for a finished residence.

    Best fit: Buyers with capital to deploy without leverage, or who want maximum flexibility in construction timeline and sequencing.

    Have the Lender Conversation Before Design Starts
    If you're financing, get your lender pre-approval process started before submitting for shop drawings. Lenders take 4–8 weeks to process a construction loan application. If you're waiting on financing approval while the shop drawings are already done and the factory is ready to start cutting panels, you're paying for delays you could have avoided.

    What Lenders Will Ask For

    Most construction lenders will require some combination of the following. DreamStart coordinates the construction documentation items:

    • Engineered drawings — coordinated by DreamStart through your design deposit, with engineering stamps coordinated when your county or lender requires them
    • Builder credentials — DreamStart provides EPS Authorized Dealer certification; the local builder provides their own credentials for the assembly labor
    • Construction cost estimate with line-item breakdown
    • Land ownership documentation (deed or purchase contract)
    • Lot appraisal or as-complete appraisal
    • Construction timeline (draw schedule)
    • Owner's credit history and income documentation
    Chapter 7

    Delivery Day

    What arrives, how it arrives, and how to be ready for it.

    Owner-builder project timeline showing the planning required before SIP panel delivery

    Delivery day is exciting and — if you're not prepared — stressful. SIP panels arrive on flatbed trailers. They're large (up to 8' × 24'), heavier than they look (up to 800 lbs for the largest panels), and need to be staged quickly so the trucking company can release the trailer without excessive unloading charges.

    Here's how to have a smooth delivery day.

    Equipment Required

    • All-terrain telehandler (SkyTrak, Lull, or equivalent) — not a standard forklift; the rough terrain capability is required
    • Fork extensions — 6' to 8' extensions for the telehandler to safely handle 8'-wide panels (available at equipment rental)
    • Come-along and 2" ratchet straps — for pulling panels together during installation
    • Banding cutters and pry bars for opening the panel bundles on the trailer
    Don't Try to Unload by Hand
    Large SIP panels weigh 3–4 lbs per square foot. An 8' × 24' roof SIP weighs approximately 700–800 lbs. Attempting to hand-carry these panels is both dangerous and damaging — panels that sag unsupported can delaminate. The telehandler is not optional.

    Staging the Panels

    Once panels are off the trailer, sort and stack them by panel ID number — matching your shop drawings. Move them as close to their final installation position as possible without blocking the work area. Important rules for stacking:

    • Always store panels flat — never standing vertically unsupported (they can tip or bow)
    • Use stickers (2×4 or 3" wide lumber) placed every 8 feet maximum under stacked panels to keep them off the ground
    • Stickers must be vertically aligned when stacking multiple layers
    • Cover panels with tarps if rain is expected — panels are rated for exterior exposure during construction, but prolonged soaking is not advisable
    • Keep first-floor wall panels staged separately from roof panels and second-floor panels (if applicable) — install in order

    Site Access Requirements for Delivery

    • Driveway and access route must accommodate a semi-truck with 53' flatbed trailer
    • Confirm clearance height under any power lines over the access route
    • Turnaround space at the site — the semi needs to be able to exit without backing a long distance
    • Confirmed, dry weather window — unloading in mud significantly complicates telehandler operation
    Chapter 8

    Assembly Week

    The 3–5 day reality of getting your shell standing.

    SIP Homestead Shell assembly milestone within a broader owner-builder project timeline

    This is the week most people imagine when they think about building a house — and in SIP construction, it's legitimately impressive. A building goes from a concrete slab to a fully enclosed, weather-tight shell in 3–5 days. The local GC crew handles the panel installation — matched and coordinated by DreamStart before they ever show up on site. Your job this week is site support and staying out of the way.

    The Daily Sequence

    Day 1
    Foundation Prep & First Wall Panels

    Sill plates installed and anchored with capillary break. First corner established — typically at a reference corner on your shop drawings. Wall panels set starting from the corner, sealant applied at each joint, panels fastened per spec. First two exterior walls are typically complete by end of day 1.

    Day 2
    Remaining Walls + Opening Headers

    Remaining exterior wall panels installed. Window and door openings verified against shop drawings. Headers confirmed in place. By end of day 2 all exterior walls should be standing and fastened. Cap plates installed.

    Day 3
    Roof Panels Begin

    Roof panels assembled on the ground where possible — I-joist or lumber splines connected, 'chicken sticks' (temporary support members) installed to maintain panel shape during lifting. Roof panel installation begins. The ridge joint is executed with extreme attention to the manufacturer's sealing detail.

    Day 4
    Roof Completion + Air Sealing

    Remaining roof panels installed. Ridge sealed per spec. All roof panel joints taped and sealed. Eave details installed. By end of day 4 the building is fully enclosed.

    Day 5
    Inspection, Touch-Up & Walkthrough

    Complete walkthrough of all joints — verify nailing/fastening is per spec, all sealant applied, all tape applied. Note any field modifications needed. Final walkthrough with local GC crew leader. Building is weather-tight and ready for mechanical rough-in.

    Critical Installation Details

    Air Sealing Is Not Optional — It's the Whole Point
    SIPs perform as well as they do because of their airtightness. A SIP building with unsealed joints is just an expensive conventional building. Every SIP-to-SIP joint, every SIP-to-plate joint, every penetration through the envelope must be sealed with SIP sealant and/or tape per the manufacturer specification. your local GC crew applies sealant as they go — but you should understand that any penetration made later by mechanical trades must be sealed with high-expanding foam immediately.
    Cutaway illustration explaining the insulated core and structural facings of a SIP wall panel
    • Sealant applied at every SIP joint before panels are pushed together
    • SIP tape applied over all exterior panel joints after installation
    • Expanding foam (low-expansion, appropriate for SIP use) applied at all sill plates and around any penetrations
    • In Missouri (Climate Zone 4/5), SIP tape is applied on the interior face at all joints
    • Ridge joint: follow manufacturer detail exactly — this is not a place to improvise
    • Brace SIPs during construction if work pauses — tall SIP walls need temporary bracing against wind before roof panels tie them together

    Post-Assembly Checklist (Walk This Before Crew Leaves)

    • All exterior joints sealed and taped
    • Ridge joint fully sealed per spec
    • All rough openings are correct size and positioned per shop drawings
    • Sill plates fastened at specified interval
    • Cap plates installed and connected at corners
    • No damaged panel faces (if any damage occurred, document and report to DreamStart immediately)
    • Shop drawings marked up with any field deviations (for your permanent record)
    Chapter 9

    Mechanical Rough-In: HVAC, Electrical & Plumbing

    SIP-specific requirements that your subs need to know before they start.

    This is the chapter that separates people who have built with SIPs from people who haven't. SIP construction has specific requirements for all three mechanical systems that your electrician, HVAC contractor, and plumber need to understand before they touch your building. Most Missouri subs have never worked in a SIP building. That's fine — but brief them with this material first.

    Electrical Rough-In

    Electrical rough-in planning for an owner-finished SIP home interior

    The good news: your factory-cut electrical chases are in the wall at exactly 14" (outlet height) and 48" (switch height), with vertical chases running every 4'. Running wire in SIP walls is actually faster than in stick-frame once you understand the system.

    • Wire enters at the bottom of the wall through the drilled sill plate, or from above through the top plate
    • Access holes for junction boxes: use a 4" hole saw at chase intersections; save the foam plug and reinstall with sealant/foam after wiring
    • Sill plates and top plates must be drilled (1.5" bit) at every chase location to allow wire passage — do this during assembly, not after
    • Additional horizontal chases requested before fabrication — cannot be field-added without manufacturer consultation
    • Interior stick-framed walls: run conduit or use open-frame wiring techniques (no pre-cut chases in conventional framing)
    • CRITICAL: Seal every electrical box penetration and chase opening with expanding foam after rough-in inspection — this preserves the building's airtightness
    • Recessed can lights in SIP roof panels: NOT recommended. Use surface-mounted or pendant LED lighting instead. Recessed cans penetrate the envelope and cannot be properly sealed.
    Seal Electrical Chases After Rough-In Inspection
    When your rough-in inspection is complete and approved, every electrical chase access hole and every penetration through the SIP envelope must be sealed with expanding foam. This is not drywall contractor work — it should happen before insulation or drywall begins. If your electrician won't do it, you do it.

    Plumbing Rough-In

    This is the most critical mechanical trade to brief on SIP construction. The rule is simple but the consequences of ignoring it are significant: no plumbing in exterior SIP walls.

    Non-Negotiable Plumbing Rule

    Plumbing supply lines must not run through exterior SIP walls. Placement of any pipe in the exterior SIP wall reduces the thermal insulation of the EPS core and in Missouri winters (Climate Zones 4–5), creates a real freeze risk. Supply lines in exterior walls can burst — and fixing a burst pipe inside a SIP panel is extremely disruptive and expensive. Design all plumbing supply runs to interior walls.

    Plumbing Solutions for Tricky Situations

    • Exterior hose bibs: use frost-free sillcocks — they don't hold water in the pipe through the wall, so freeze risk is eliminated
    • Vent stacks: route vent pipes through interior walls to the roof. If a vent must go through an exterior SIP wall, consult DreamStart before cutting — manufacturer or engineer approval required
    • Kitchen island sinks: use island vent / air admittance valve option — eliminates need for vent pipe through roof for the island fixture
    • Plumbing against exterior wall: fur out the interior face of the SIP wall (add a 2×4 stud wall inside) to create a service cavity for pipes
    • Minimize roof penetrations: consolidate vent stacks where possible; fewer roof penetrations = better air sealing = better performance
    • Roof penetrations that are necessary: apply high-expanding foam around every vent pipe where it exits the SIP roof panel — include this in your plumber's scope of work

    HVAC — The Most Important Sub Brief

    This is where most SIP owners get overcharged and underperformed. Your HVAC contractor is almost certainly going to try to install a system that's too large for your building. This is not malice — it's habit. Old rules of thumb for sizing HVAC equipment (like "1 ton per 600 sq ft") were developed for leaky, poorly-insulated stick-frame houses. A Solid-Core SIP building is not that building.

    Oversized HVAC Is Not Just Wasteful — It's Damaging
    An oversized HVAC system "short cycles" — it runs for short bursts, reaches setpoint, and shuts off. Short cycling means it never runs long enough to remove humidity from the air. In summer, that means 70% relative humidity inside your beautiful new building — mold conditions. In winter, it means uneven temperatures and excessive wear on equipment. A properly sized system for a SIP home is typically 30–50% smaller than what the same square footage would require in a stick-built house.
    • Require your HVAC contractor to perform an ACCA Manual J load calculation — not a rule-of-thumb estimate
    • Provide your contractor with the building's actual R-values: R-26+ walls, R-40+ roof, window specifications
    • SIP buildings are very airtight — mechanical ventilation (HRV or ERV) is required for indoor air quality and code compliance
    • ERV (Energy Recovery Ventilator) is preferred in Missouri's climate — recovers both heat and humidity
    • Mini-split heat pump systems are highly compatible with SIP construction and are increasingly cost-effective
    • Ductwork should be run in conditioned space wherever possible — insulated attics are not needed in SIP roofs since the roof IS the insulation
    • SIP roofs create a conditioned attic space by default — this is a feature, not an oversight; it means mechanical equipment in the attic doesn't suffer from extreme temperature swings
    Chapter 10

    From Shell to Move-In

    What happens after the assembly crew leaves — and how to sequence interior work.

    Once your shell is standing and weather-tight, you have time. The shell protects your investment while you work through interior finish at whatever pace your budget allows. This is one of the genuine advantages of the owner-builder path — you don't have to finish everything before you move in if your county doesn't require it (and many don't).

    Recommended Sequence for Interior Finish

    Phase 1
    Rough-In (4–8 weeks after assembly)
    • HVAC ductwork and mechanical equipment rough-in
    • Electrical rough-in and panel installation
    • Plumbing rough-in (supply, drain, vent)
    • Inspection(s) — required if in a permit county
    • Seal all chases and penetrations after inspection approval
    Phase 2
    Insulation & Drywall
    • Interior walls insulated if desired (SIP exterior walls need no additional insulation)
    • Vapor barrier on ceiling per climate zone requirements
    • Drywall hung, taped, mudded, and sanded
    • Drywall is your primary interior air barrier — tape and mud every joint carefully
    Phase 3
    Doors, Windows, Trim
    • Exterior doors and windows installed (may have been done at shell completion for weather-tight status)
    • Extension jambs on windows and doors — SIP walls are slightly thicker than conventional; jambs must be ordered to match actual wall thickness
    • Interior trim, casing, baseboards
    Phase 4
    Flooring, Paint, Cabinets
    • Concrete slab prep or subfloor over sleepers if doing wood floors
    • Paint interior walls
    • Kitchen and bath cabinets installed
    • Countertops
    Phase 5
    Fixtures, Finishes, CO
    • Electrical fixtures and switches
    • Plumbing fixtures, toilets, water heater
    • HVAC equipment start-up and commissioning
    • Final inspections (if permit county)
    • Certificate of Occupancy (if applicable)

    Windows and Doors in SIP Walls — A Note on Extension Jambs

    SIP walls are slightly thicker than conventionally framed walls — a 6.5" SIP wall is about 7/16" thicker than a standard 2×6 wall because of the second OSB facer. Window and door manufacturers can accommodate this, but you must specify the correct wall thickness when ordering. Most manufacturers offer extension jambs in custom depths. Confirm your actual SIP wall thickness with DreamStart before ordering windows and doors.

    Hiring Subcontractors in Rural Missouri

    Start your sub search early — 6–8 weeks before projected shell completion is not too soon. In rural Northwest Missouri, licensed electricians and plumbers are not always immediately available. Tips:

    • Get referrals from local lumber yards — they know who's active and who's reliable
    • Be upfront about SIP construction when calling subs — some will say no; others are curious and willing to learn
    • Share this guide's mechanical sections with any sub who hasn't worked in SIP construction before
    • Get bids from at least 2–3 contractors for each trade
    • Ask specifically about their experience with tight building envelopes and mechanical ventilation
    • Electrical: find a licensed master electrician; wiring runs through factory-installed chases, which most electricians adapt to quickly
    Chapter 11

    Missouri Resources & Contacts

    The phone numbers, websites, and organizations you'll actually use.

    DreamStart Building Company

    Based in St. Joseph, MO. EPS Authorized Dealer. SIP panels factory-cut in Graettinger, Iowa.

    Phone: (816) 388-0462

    Email: dreamstartbuilding@gmail.com

    Calculator: dreamstartbuilding.com/homestead-shell-calculator

    Missouri Permitting & Regulatory

    • Missouri Building Codes — no statewide residential code; contact county P&Z or assessor directly
    • Missouri DNR Well Construction Permits: mdnr.mo.gov | (573) 751-4817
    • Missouri DNR Onsite Wastewater (Septic): mdnr.mo.gov | permits issued through county health departments
    • FEMA Flood Map Service Center (check your parcel): msc.fema.gov
    • Missouri Department of Revenue — property tax and owner-builder exemptions

    Financing Resources

    • USDA Rural Development Missouri: rd.usda.gov/mo | 1-800-670-6553 — check rural eligibility map before applying
    • Farm Credit Mid-America (covers most of Missouri): farmcreditma.com | multiple Missouri offices
    • Missouri Agriculture Mediation Program (if farm property involved): mamp.org
    • Missouri Housing Development Commission (MHDC): mhdc.com — first-time buyer programs
    • DreamStart Financing Guide: dreamstartbuilding.com/barndominium-financing

    Technical Standards & References

    • SIPA (Structural Insulated Panel Association): sips.org — free download of SIP Best Practices, Builder and Designer guides
    • SIPA Master Code Report ESR-4689 — the primary code evaluation report for SIPs used by plan reviewers
    • ACCA Manual J — the HVAC load calculation standard; require your HVAC contractor to use it
    • DOE Building America Best Practices (SIP edition): energy.gov/eere/buildings — free reference for mechanical system design in tight buildings
    • APA – The Engineered Wood Association: apawood.org — SIP product guide and ANSI/APA PRS 610.1 standard

    More DreamStart Guides

    Ready to Start Your Missouri Homestead Shell?

    Use our calculator to get a square-foot estimate for your build, or call us directly to talk through your site, your plan, and what it actually costs to get a shell in the ground in Missouri.
